GitHub and Project Management

Guidelines

These guidelines are meant to ensure that issues are created in a standardized format and contain sufficient detail so we know what needs to be done, how much effort is involved, and how to prioritize it against other issues.

  1. Title: This can be short, but should give enough detail to identify what work this issue is related to and differentiate it from similar task. For example, “Review Documentation for [Specific Project Name]”, as opposed to “Review Documentation” which is too vague.
  2. Description: This should be detailed enough that anyone viewing the issue knows what work needs to be done, and what the ideal outcome or deliverable is once this work is complete (success criteria).

    1. If the work can be broken out into subtasks, make use of the checklist format option to list those subtasks. pm-subtasks
    2. Meta-issues: If the issue is sized Large (1-2 weeks of work) or X-Large (more than 2 weeks of work), turn it into a meta-issue. The subtasks should be turned into their own issues and linked back to this issue. This should also be done if subtasks need to be assigned to someone other than the primary driver of the issue.
    3. Sub-task issues should be sized appropriately so that they can be completed in <1 sprint of work. So Tiny (1 hour), Small (1 day), and Medium (1 week) are appropriate sizes for sub-tasks. A Large (2+ weeks) or X-Large (months) task should be broken up into smaller components and turned into a meta-issue.

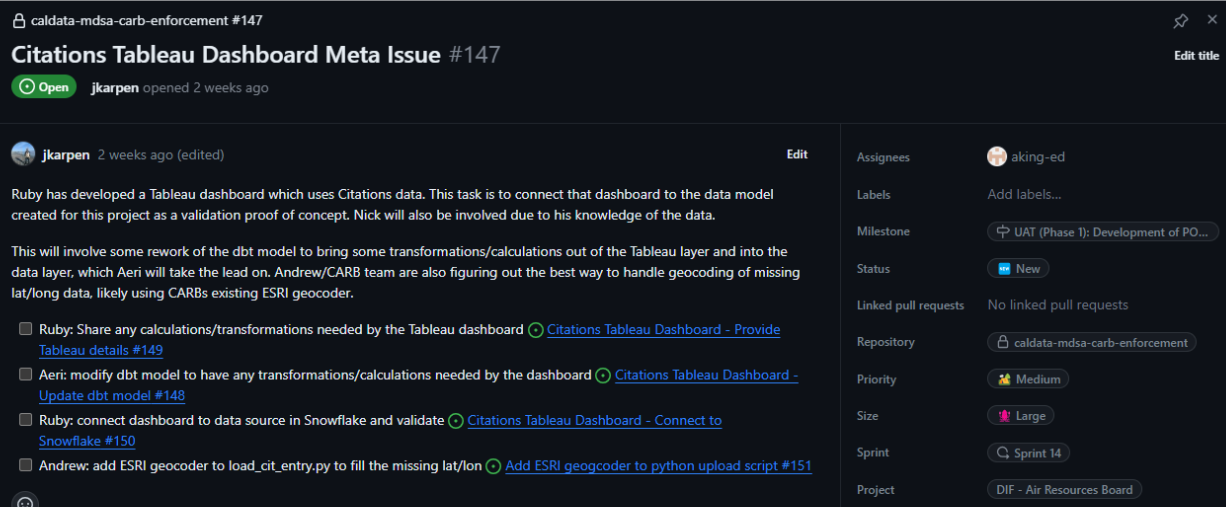

    4. Example Meta-Issue: Note that in the screenshot below, there is text between the check-box and the issue name. This will prevent the automation that checks the box when the issue is closed from working. To enable that automation, there should be no text in the check-box besides the issue name. pm-eg-metaissue
  3. The following items should always be filled in when creating a new issue. If you are unsure what to enter, reach out to the Project Manager to discuss, or bring it up in daily standup or weekly sprint planning meetings to discuss with the team.

    1. Assignee: If you are unsure who to assign the item to, assign it to yourself to avoid losing track of the issue. Then add a comment that you think it may need to be assigned to someone else and we can discuss in the next team meeting.
    2. Priority: Indicates how soon the work needs to start. See definitions in the appendix at the end of this document.
    3. Size: Indicates how much time the work will take to complete once it has started. See definitions in the appendix at the end of this document.
    4. Sprint: We track work using two-week sprint cycles. Sprint names follow the a convention of [current year]-[sequential sprint number]. So the first sprint of the year 2025 is "2025-01". The last sprint of the year 2025 is "2025-26".
      1. If work on an issue or task will start within the next 2 sprints, assign it to the appropriate sprint during Sprint Planning meetings. Work planned further than 2 sprints out does not need to be assigned to a sprint and can be left in the backlog, unless there is a known due date or we want to make sure something starts at a certain date.
    5. Project: This field is important because it ensures the issue is grouped with the correct project in our Project Board. If you are unsure of the project to choose, the Project Manager can help.
      1. Projects associated with DIF work start with “DIF - “ followed by the project name.
      2. Tasks related to overall ODI infrastructure changes not tied to a specific project can go in the appropriate Infrastructure projects. This should be used by DSE team members only.
    6. Milestone: Most DIF projects have Milestones which map to our project timelines. There is a search function which can help identify the correct milestone for the work being done. The Project Manager can help if you are not sure of the correct milestone.
      1. Note: If a project repo does not have milestones created (for example the ODI data-infrastructure repo) then this can be left blank.
    7. Due Date: Assign a due date when the work needs to be completed by a certain date, if applicable. If there is no set due date this can be left blank.
    8. Status: Assign a status on the current state of the issue. See below for status options.
  4. Pull Requests: Add phrase “(Fixes/Closes/Resolves) #xx” to ensure the referenced issue gets closed when PR is merged
    1. We will review “Open PRs” tab during stand up.
  5. Make sure to fully close an issue when completed by scrolling to the bottom and choosing "Close Issue".

Size Definitions

Tiny

  • Easy task, something that can be completed in about an hour. If something takes less than 30 minutes, no need for an issue unless it will help serve as a reminder to complete something.
  • Example: Sending a follow-up email

Small

  • A task that can be completed in one day
  • Example: Reviewing documentation on an API to determine how to onboard a new data source.

Medium

  • A task that can be completed in about a week
  • More complex but still straightforward to complete
  • Example: Creating a staging or intermediate data model for a source that is well-understood and does not require complex logic.

Large

  • A task that can be completed in 2 or more weeks
  • Increased complexity, may require slower manual work or unknowns that require research and discovery
  • Example: Writing an API script for a new, unknown data source.

X-Large

  • Tasks that may take a month or longer to complete
  • Consider breaking up into sub-tasks if possible, or create a meta-issue when there are dependencies
  • Example: Building a full set of end-to-end models for a new data source, including staging, intermediate, and mart models.

Priority Definitions

Urgent

  • Top priority, usually reserved for unexpected emergency item.
  • Putting everything else on backburner, aiming for completion ASAP
  • Not assigned as part of regular sprint planning process

High

  • Goal is to complete this sprint
  • Must stick to Due Date if established

Medium

  • Less important than High, aim to complete within 2-4 sprints
  • OK to push to next sprint if needed

Low

  • Work on as time allows, may leave in backlog

Status Definitions

  1. New: Default for new issues. If discussion is needed to clarify details about the issue leave it as New until that discussion happens (so it appears in the “New Status” Project Board view).
  2. Backlog: If work is not planned on this within the next 2-3 sprints, set the Status to Backlog (or Blocked if the work is blocked for any reason) and do not assign it to a sprint.
  3. TODO: If the issue is assigned to a sprint but work has not started yet, set the status as TODO.
  4. In Progress: Choose this status once work has started on the issue.
  5. Needs Review: Indicates that review is needed from other team members.
  6. Blocked: Choose this if work on the issue cannot move forward due to something outside of your team’s control, for example if waiting on another team to respond to a question.
  7. Paused: Work has started on this task but has been put on hold due to competing priorities.
  8. Done: Indicates the issue is completed. This status is set automatically when the issue is closed, you do not need to select it.
    1. Note: The correct way to close an issue is to scroll to the bottom of the issue page and choose “Close Issue”.
